IMPORTANT
Water flowing through Battle Creek

Battle Creek Hydroelectric Project

Learn about PG&E's plan to decommission this project

Overview

PG&E owns and operates the Battle Creek Hydroelectric Project in northeast California. The Federal Energy Regulatory Commission (FERC) issued the project's 50-year license in 1976. The project is located along the North and South Forks of Battle Creek in Shasta and Tehama counties. The project uses water for power generation from these forks, plus several tributaries and springs.

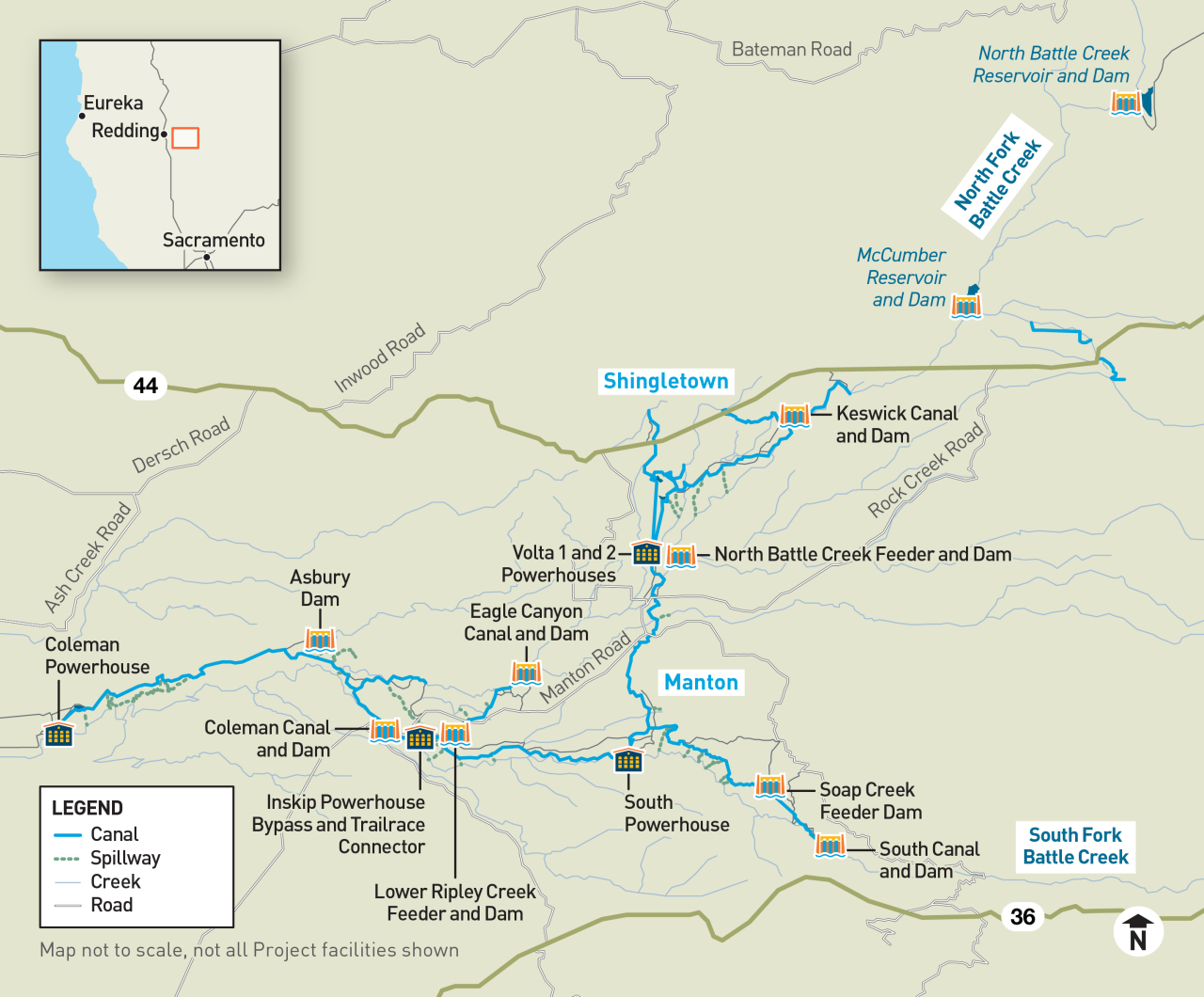

The project consists of several types of facilities. These include dams, canals, pipes and powerhouses. Some of these facilities are more than 100 years old. They occupy PG&E-owned, private and federal lands.

Storage reservoirs icon

Two upstream storage reservoirs

Forebays icon

Three forebays

Canals and pipelines icon

20 canals and pipelines

Dams icon

15 diversion dams

Fish screens icon

Two fish screens and ladders

Powerhouses icon

Five powerhouses

In 2020, PG&E decided not to apply for a new FERC license. We decided running the project was too costly for our customers.

In early 2021, FERC issued a public notice of interest. The notice was to see if any other groups were interested in taking over operation of the project. FERC received no responses from interested third parties.

In late 2022, FERC required PG&E to plan for surrender of the project. PG&E is currently developing the License Surrender Application (LSA). FERC must approve the application before any decommission starts.

A stream running through a forest

Decommissioning

PG&E is giving up the federal license that allows it to operate the Battle Creek Hydroelectric Project. This process is called a license surrender. In 2020, PG&E decided not to apply for a new FERC license. We decided it was too costly for our customers. PG&E reviewed other options, including whether a third party might take it over. When no third party expressed interest, FERC required PG&E to begin the license surrender process.

PG&E is preparing the LSA and proposed decommissioning plan now. It will go to FERC for approval. Federal rules require PG&E to file the LSA before decommissioning takes place.

What does decommissioning mean? What is a decommissioning plan?

Decommissioning means safely retiring energy facilities. For the Battle Creek Hydroelectric Project, this may include:

  • Removing or changing equipment and structures
  • Leaving some structures in place if they can remain safely
  • Restoring land and waterways impacted by decommissioning activities

A decommissioning plan explains how this work would be done safely. PG&E would develop this plan with input from:

  • Agencies
  • Landowners
  • Tribes
  • Other stakeholders

License Surrender Application

The final LSA will include:

  • Reason for surrender application and a copy of the existing license and amendments
  • Description of existing Project facilities and proposed decommissioning plan
  • Environmental report assessing potential decommissioning impacts to environmental resources
  • Proposed measures addressing potential construction impacts

The FERC processes the LSA to ensure it is complete. Once complete, FERC will issue a public notice. The notice will include at least a 30-day public comment period. Read more about the surrender process.

Decommissioning process

There are several ways Battle Creek Hydroelectric Project structures can be decommissioned.

Possible decommissioning options

Circled x icon

Structure left in place

Lock icon

Structure changed to ensure long-term safety

Excavator icon

Structure retired and buried in place

Truck icon

Structure retired and taken off site

To develop the LSA and decommissioning plan, PG&E will work with many:

  • State and federal agencies
  • Landowners
  • Tribes

Some infrastructure may eventually be changed or retired. The decommissioning plan will consider:

  • Public safety
  • Environmental and cultural resources
  • Maintenance and monitoring

Project timeline

PG&E has begun planning and preparing for the development of the surrender application. The company has also begun its stakeholder outreach efforts.

The LSA will be developed with opportunities for public input. The LSA will include a proposed decommissioning plan. The plan describes how Battle Creek Hydroelectric Project facilities and infrastructure will be safely shut down.

The license surrender process will take many years. PG&E will continue to operate the project under current license conditions until physical decommissioning begins. This includes regular canal outages in the spring and summer. These seasons are when the canals will be dewatered for regular maintenance. Changes to project facilities resulting from this process aren't planned until the mid-2030s.

Schedule for the Battle Creek Hydroelectric Project License Surrender process from 2025 to 2031. Preparation of the License Surrender application runs from 2025 to 2028. Stakeholder engagement runs from 2026 to 2028. Draft comment periods occur in late 2026 and mid-2027. Final filing of the License Surrender application with the Federal Energy Regulatory Commission occurs in 2028. Design and permitting occurs in 2030. Decommissioning activities would begin in the mid-2030s or later. Dates are subject to change.

Public input

PG&E is committed to providing you with clear communication. PG&E will be holding a virtual informational meeting. The meeting will provide information about the Battle Creek Surrender process. It will also provide information about opportunities for the public to comment.

Events

Virtual Information Session: March 31, 2026, from 5:30-6:30 p.m.

Event registration information coming soon

Frequently asked questions

In 2020, PG&E decided not to apply for a new FERC license to continue running the project. We decided it was too costly for our customers. PG&E reviewed other options, including whether a third party might want to take over the Project. When no third party expressed interest in the Project, FERC required PG&E to begin the license surrender process.

Decommissioning means safely retiring energy facilities. For the Battle Creek Hydroelectric Project, this may include:

  • Removing or changing equipment and structures
  • Leaving some structures in place—if they can remain safely
  • Restoring land and waterways impacted by decommissioning activities

decommissioning plan explains how this work would be done safely. PG&E would develop this plan with input from:

  • Agencies
  • Landowners
  • Tribes
  • Other stakeholders

Protecting the environment is a priority for PG&E. The license surrender application will include an assessment of potential project impacts. PG&E will work closely with state and federal agencies to minimize potential impacts.

Water rights are not a part of the FERC license surrender process. PG&E will evaluate the long-term strategy for its existing water rights. Evaluation happens after the License Surrender Application has been submitted to FERC for review. In the meantime, PG&E will continue to operate the project in compliance with existing license requirements and laws. Some infrastructure may be modified, removed or left in place. The decommissioning process will be managed to ensure clear and timely communications. Communication will be with interested stakeholders.

No. The Battle Creek facilities are small. They don't play a critical role in PG&E's overall power supply. Electricity needs will continue to be met through other sources.

The license surrender process will take many years. PG&E will continue to operate the project under current license conditions until physical decommissioning begins. This includes regular canal outages in the spring and summer. These seasons are when the canals will be dewatered for regular maintenance. Changes to project facilities resulting from this process aren't planned until the mid-2030s.

Yes. PG&E values input from residents, stakeholders, and tribal communities. There will be virtual information sessions, comment periods, and ongoing outreach to ensure transparency.

PG&E is committed to a responsible and respectful decommissioning process, guided by:

  • Compliance with all federal and state regulations
  • Environmental assessments
  • Transparent communication with stakeholders
  • Ongoing monitoring and safety planning

Contact us

Your voice and support matter to us. Please send any comments or questions to BattleCreekHydro@pge.com.
